The City of Germantown’s commitment to advancing exceptional quality of life and making great spaces is dependent on an integrated park system that provides abundant access to a vast array of natural beauty and extraordinary experiences. With community growth and evolving needs, the City of Germantown takes great pride in enhancing public spaces and contributing to healthy, sustainable practices and opportunities. Germantown will continue to reinvest in neighborhood parks, expand existing facilities and meet residents’ changing needs.
Continue to reinvest in neighborhood parks, enhance existing facilities and meet residents' changing needs.
Analysis:

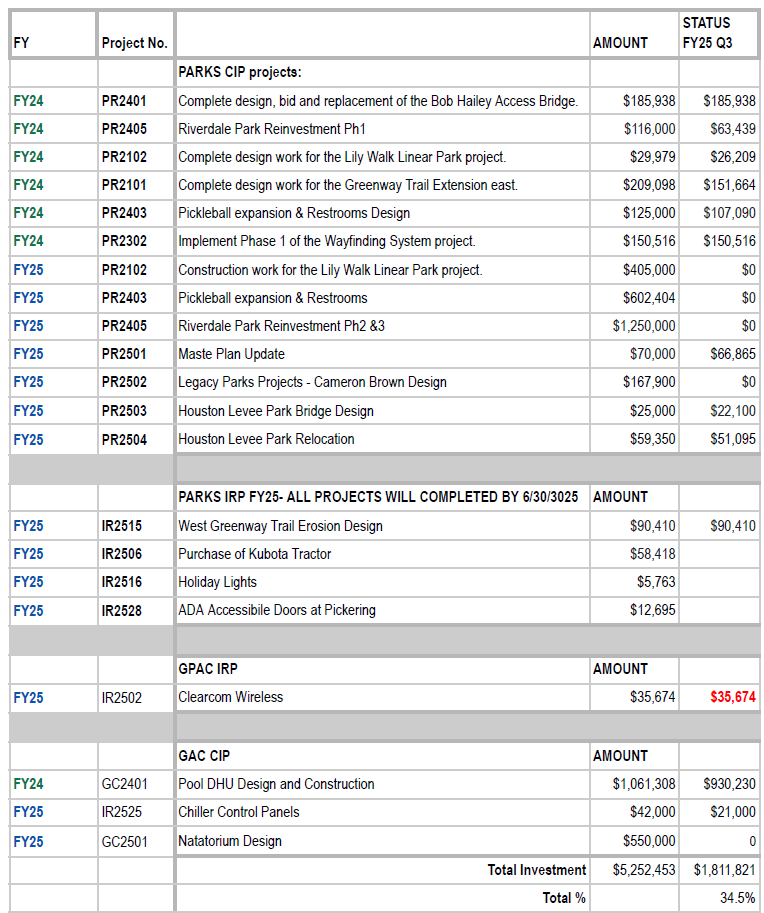

All projects are in progress with encumbered PO's for all of the $2,025,011.
- CIP - There are 2 of the 7 are completed with the other 5 in construction or in the final stages of design.
- IRP - 4 of the 5 are completed. Staff is waiting Playground equipment to arrive.
FY24 RE-INVESTMENTS |
AMOUNT |
STATUS |
PARKS CIP Projects: |
|
|
Complete design, bid and replacement of the Bob Hailey Access Bridge. |
$200,000 |
IN PROGRESS |
Complete design and installation of the DIDD Inclusive Playground Grant at Municipal Park. |
$537,761 |
COMPLETED |
Complete design work for the Pickleball Expansion and Restrooms. |
$125,000 |
IN PROGRESS |
Complete design work for the Lily Walk Linear Park project. |
$343,000 |
IN PROGRESS |
Complete design work for the Greenway Trail Extension east.. |
$132,000 |
IN PROGRESS |
Complete Phase II of the Germantown Station Park reinvestment project. |
$275,000 |
COMPLETED |
Implement Phase II of the Wayfinding System project. |
$150,000 |
IN PROGRESS |
Total CIP Parks: |
$1,762,761 |
|
|
|
|
PARKS IRP Projects: |
AMOUNT |
STATUS |
Maintenance Equipment |
$87,000 |
COMPLETE |
Greenway Repair and Overlay |
$75,000 |
COMPLETE |
Park Playground Improvements |
$65,000 |
IN PROGRESS |
Farm Park Fence |
$25,000 |
COMPLETE |
Weather Station and Outdoor Warning System |
$10,250 |
COMPLETE |
Total IRP Parks: |
$262,250 |
|
Impact:
The city has a moderate impact on this measure.
The City of Germantown is committed to offering and developing an array of public art experiences and commissions artists through a variety of media and scales to celebrate the people, history and spirit of Germantown.
Analysis:
Strategies are broken into short, medium and long term tiers. Collectively, the plan is ambitious and will require public support and funding through strong leadership to accomplish all of the goals. The short term goals and strategies of the Public Art Master Plan are on track to be complete at the end of Q4 FY24.
Impact:
The city has a moderate impact on this measure.
Continue to reinvest in neighborhood parks, expand existing facilities and meet residents' changing needs.
Analysis:
Advance the Parks and Recreation Master Plan by completing the FY25 CIP projects.
- Complete the replacement of the Bob Hailey Access Bridge.
- Complete the update to the Comprehensive Parks and Recreation Master Plan.
- Complete the design work for the parking expansion at Cameron Brown Park.
- Continue the research and development of the Premier Sports Complex.
- Complete design work and construction for the Pickleball Expansion and Restrooms
- Complete design work for the Lily Walk Linear Park project.
- Complete design work for the Greenway Trail Extension east.
- Complete design work and construction for the Phase II of the Riverdale Park Reinvestment project.
- Complete construction for Phase I of the Wayfinding System project.
Continue park and facility reinvestments through the completion of IRP projects.
- Complete the West Greenway Trail Erosion project.
- Complete the purchase for the Kubota Tractor.
- Purchase banners for the holiday season.
- Purchase and install ADA Accessible Doors for the Pickering Center.
Impact:
The city has a moderate impact on this measure.
Administration is responsible for coordination and dissemination of information that is communicated to the Public. The Chief Communications Officer is responsible the Communications Plan development and implementation to City Staff. The community survey is the method in which we measure the Customer satisfaction.
Analysis:
This is the aggregate QoL measure from the survey.
- 2023 Survey respondents were asked how satisfied they are living in Germantown. Ninety percent responded being very or somewhat satisfied.
- In the 2018 survey, 97 percent said that Germantown was an excellent or a good place to live.
* The City did not administer a Community Survey in FY19, FY20, FY21 and FY22. A community survey will be conducted during the 2nd quarter of FY25.
Impact:
The City has a high impact on this measure
